Metric-driven change management

Change management is hard. Getting a team to actually shift behaviour, not just nod at a new process, is harder. Metrics make it possible.

There are as many books and articles on change management as there are approaches to adopting a new methodology. That volume alone signals the complexity. Alignment and resistance to change are the two obstacles that defeat most initiatives before they gain traction.

This post shares a real example from Klipfolio's development team, and a reusable framework you can apply to your own organization.

What is metric-driven change management?

Metric-driven change management (MDCM) is an approach to process improvement that uses a small number of clear, agreed-upon metrics and targets to align teams and sustain behavioural change.

Instead of relying on policy documents or management pressure, MDCM gives everyone a shared scoreboard. When the number is in range, the team keeps moving. When it drifts out of range, the team knows exactly what to fix and why.

Why metrics make change stick

Most change initiatives fail not because the idea was wrong, but because no one agreed on what "better" looks like. Without a number, progress is a matter of opinion. With a number, it's a fact.

Metrics do three things that process documentation cannot:

  • They remove ambiguity. "Improve product quality" is a goal. "Fewer than three critical issues open at any time" is a target. One is open to interpretation; the other is not.
  • They create shared accountability. When the metric lives on a team dashboard, everyone sees the same number. No one can claim they didn't know.
  • They make the conversation easier. When a target is missed, the discussion is about the number, not about blame or opinion.

The problem we were solving at Klipfolio

As Klipfolio grew its customer base and product functionality, managing product defects became increasingly difficult. The challenge was not identifying bugs; it was prioritizing them against everything else competing for developer time: new features, enhancement requests, technical debt, and R&D work.

Different departments had different priorities. Customers with louder voices got their issues fixed first. In the worst cases, defects fell through the cracks entirely.

We started by improving the review process itself. Support, Product Management, QA, and Development began meeting regularly to categorize and prioritize incoming defects using two categories:

Critical: Defects that block several customers, or where a service has stopped working.

Major: Defects affecting one or more customers' experience, or where a major feature does not work as expected.

That helped within the defect pool. It did nothing to resolve the broader competition for resources across the entire development backlog.

The two metrics that changed everything

We solved the prioritization problem by introducing two simple metrics and getting everyone, including senior leadership, to align on the targets:

  • Number of critical issues must stay under 3
  • Number of major issues must stay under 10

That's it. Two numbers. Two targets. Company-wide alignment.

When we started, we had more than 10 critical issues and 30+ major issues open at the same time. The conversation about what to fix first was constant, draining, and political.

Once the targets were set and agreed upon, the conversation became simple: if either number exceeds the target, defect fixes take highest priority in the next sprint. No negotiation. No ambiguity. No one waiting for someone to pull a report and explain the situation from scratch.

These metrics now appear on our development team dashboard. They're not a project; they're part of the culture.

What happened next

Once the team consistently hit both targets, we raised the bar with two new metrics:

  • Number of critical issues older than 2 days must be 0
  • Number of major issues older than 10 days must be under 5

This is the iterative nature of MDCM. You don't define every metric upfront. You start with the most important ones, reach the targets, then layer in the next level of precision.

The MDCM framework

The following diagram shows how to apply this approach in your own organization. The framework covers six steps: decide what needs to change, select the metrics that enforce the change, identify the key players, get alignment on the metrics, monitor results, and iterate.

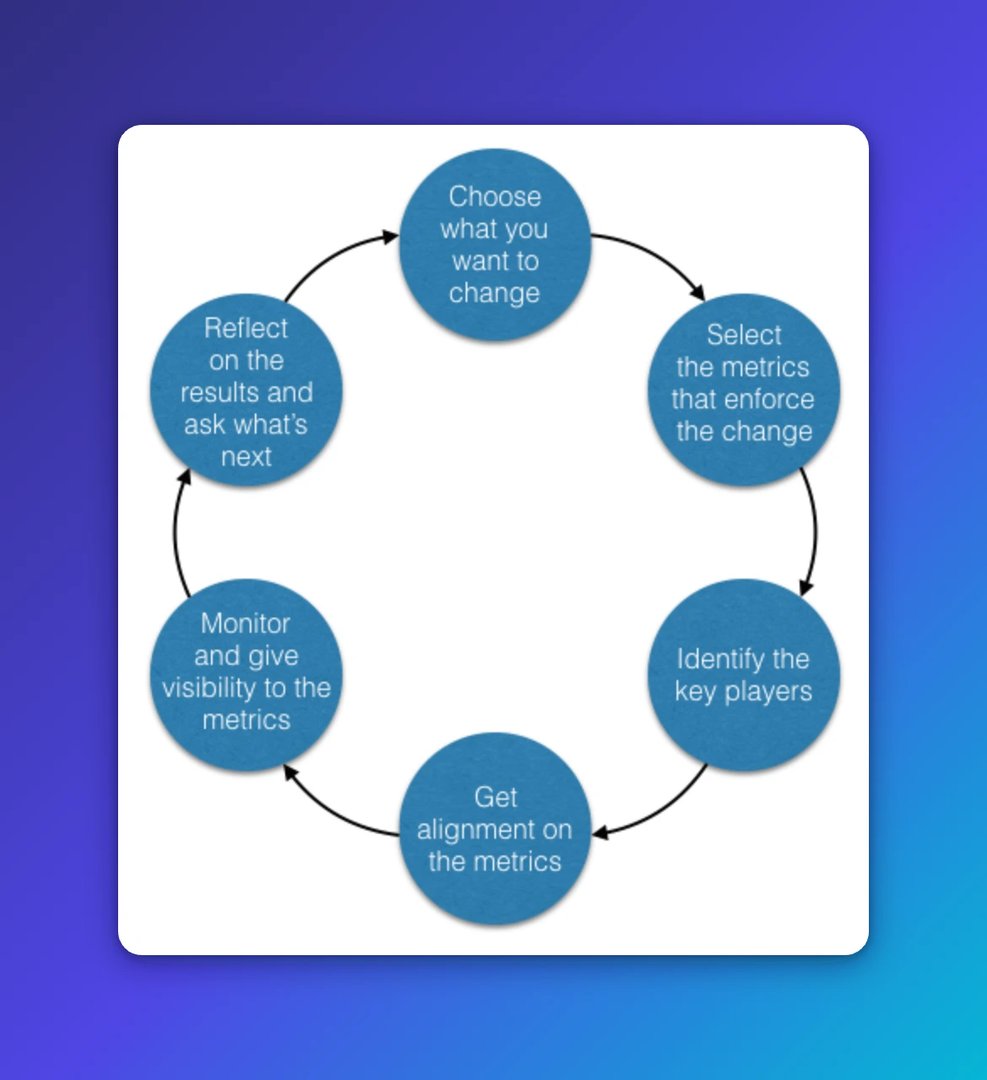

Circular diagram showing six steps for metric-driven change: choose what you want to change, select the metrics that enforce the change, identify the key players, get alignment on the metrics, monitor

The next diagram applies the framework to the example from this post, so you can see what a completed blueprint looks like in practice.

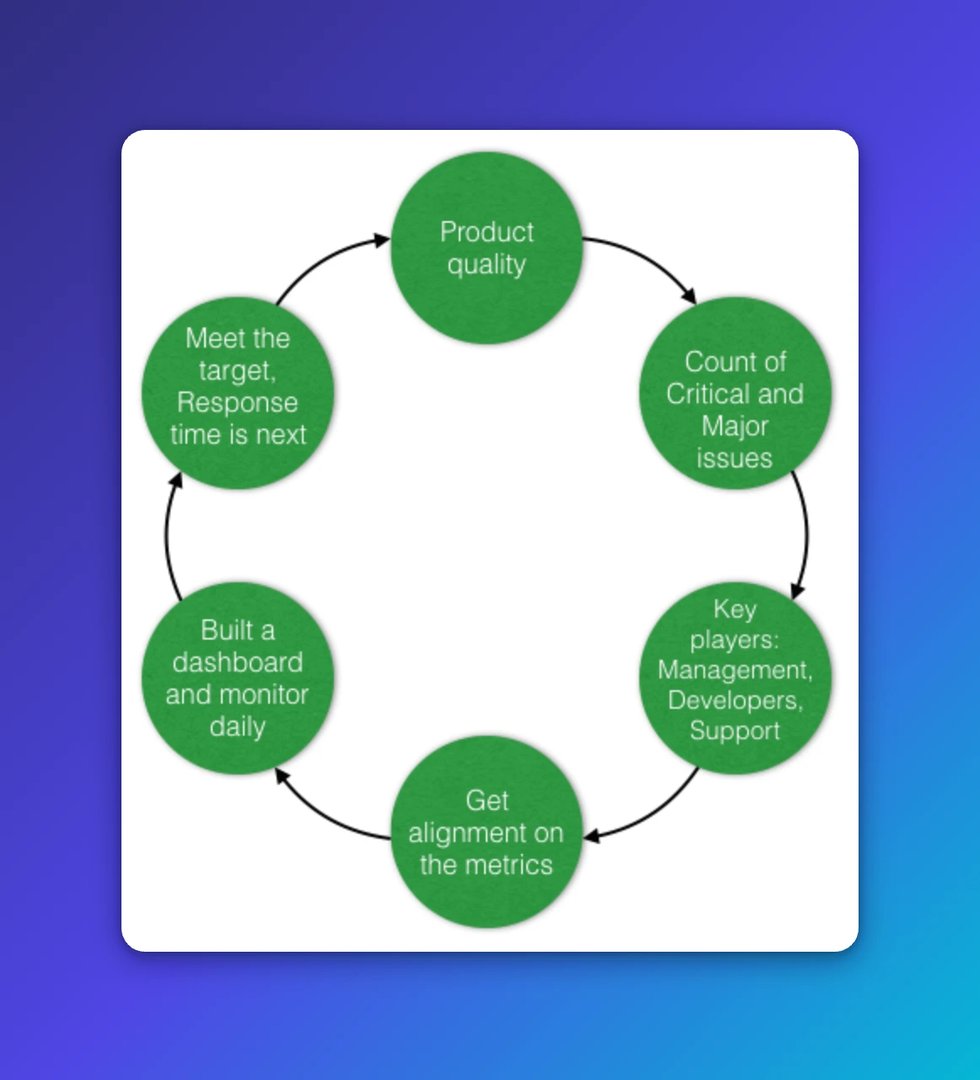

Circular diagram showing six interconnected steps for metric-driven change: Product quality, Count of Critical and Major issues, Key players (Management, Developers, Support), Get alignment on the met

Klips logo Level up your decision making

Create custom dashboards for you and your team.

Get started with Klips

How to apply MDCM in your organization

The mechanics transfer to almost any team or department. A few things determine whether it works:

  • Keep the metrics simple. If someone has to explain the metric before discussing the target, it's too complex. Every person in the room should be able to hold the number in their head.
  • Get leadership aligned first. Metrics that live only inside one team have limited force. When senior leadership is on record with the same targets, prioritization decisions become much easier to defend.
  • Put the metrics somewhere visible. A number buried in a spreadsheet is not a shared scoreboard. A dashboard that everyone can see, without having to ask someone to pull it, is.
  • Treat the target as a floor, not a ceiling. Once you're consistently hitting a target, tighten it. MDCM is iterative by design.

The goal is not perfect process documentation. The goal is that everyone in the organization knows what "good" looks like today, can see whether you're there, and knows what to do when you're not.
